Mohmand Dam Hydropower Project .....800 MW

. . .









. .

Inaugration of Crushing Plant at Mohmand Dam - 800MW
🏗


The Crushing plant is located at right bank of Swat River. To meet the aggregate requirement for the construction of dam and axillary structures, the plant has been erected which will help to accelrate the construction progress.







. .

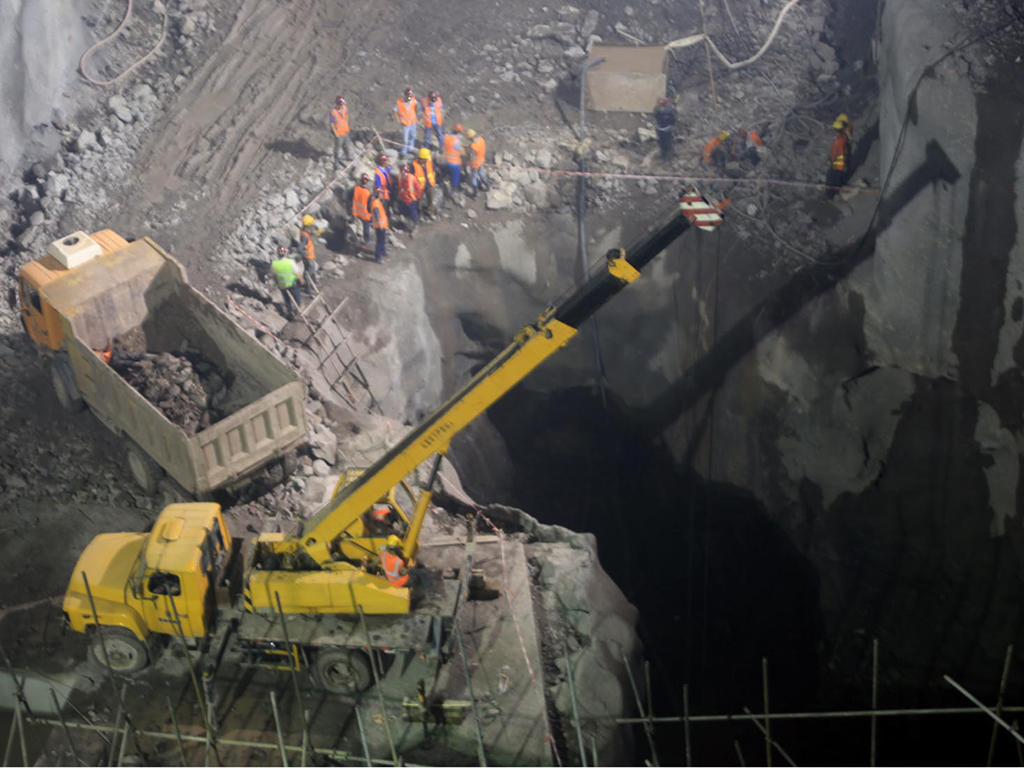

On 6th July, 2021, another achievement registered at Mohmand Dam. The Excavation faces breakthrough with each other from Diversion Tunnel no.1.

The diversion tunnels are key line of the project to timely divert the river flow and start the main dam construction. It is pertinent to mention here that to expediate the progress, the working from 4 location on twin diversion tunnels are in progress.














. .
Mohmand Dam Project | Construction Activities
July, 2021


Jul 11, 2021




.
Visit of Federal Secretary for Ministry of Water Resource to Mohmand Dam in Lower Mohmand Sub-Division on 14th July.
He was briefed about work progress, land acquisition and security arrangements.

.
Under Construction Mohmand Dam Hydropower Project - 800 MW
Under Construction since September 2019
Gross Storage 1.2 MAF
Annual Energy Production 2,862 GWh
Completion date: 2025













.
On 28th July, 2021, another achievement marked at Mohmand Dam.
The excavation faces breakthrough with each other from Diversion Tunnel no.2. Both tunnel sections breakthrough with high-accuracy alignment.








.
Mohmand Dam Hydropower Project - 800 MW
Under Construction since September 2019
Gross Storage 1.2 MAF
Annual Energy Production 2,862 GWh
Completion date: 2025
















.
Two diversion tunnels having 15m diameter are being excavated on the right bank. The excavation and support activities are going on around the clock. To accelerate the diversion of river swat, the tunnels are being excavated from multiple work fronts. The total length of both tunnels is about 3,300m.



.
